If you’re planning interiors for your 2 BHK home in Mumbai, the biggest question on your mind is usually the same:
“How long will the whole interior work take?”
We get this every day from new home buyers and families shifting into their apartments. So in this blog, I’ll break down the entire interior timeline in a simple way — from design to handover.
You’ll see exactly how long a 2BHK interior takes, what causes delays, and how you can keep the project on track.
Let’s start with a quick summary.
Quick Summary — Typical 2 BHK Interior Timeline in Mumbai
If you just want the quick answer before diving deeper, here’s the standard 2BHK interior timeline most good designers follow in Mumbai.

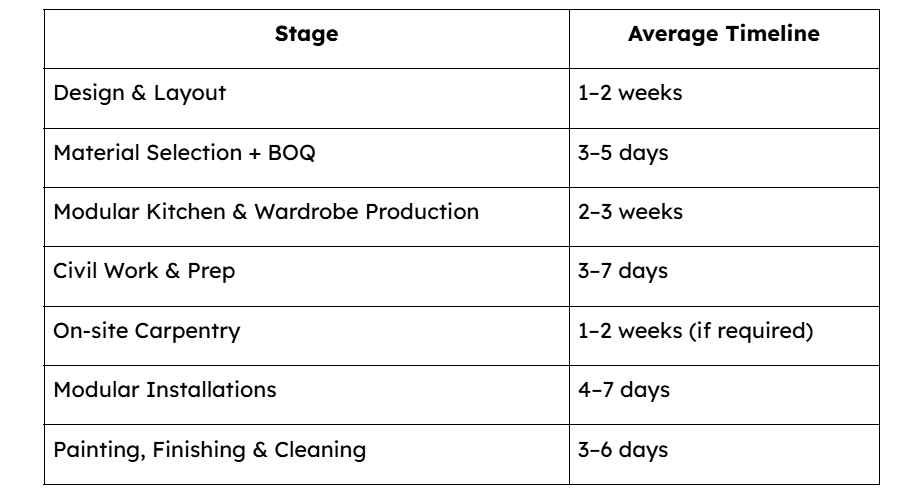

Average Time Chart for 2BHK Interiors
Total 2BHK Interior Timeline in Mumbai: 4–6 weeks
(This depends on scope, building rules, approvals, and material choices.)
Why Mumbai Homes Take a Specific Timeline (Local Factors That Matter)
Mumbai interiors move at a different rhythm because the city has its own style of functioning. Here are the real reasons:
- Society rules: Most societies allow work only between 10 am to 6 pm, or sometimes just 11 am to 5 pm.
- Lift usage restrictions: You can’t move plywood or modular units anytime you want.
- Compact flats: 2BHK homes need faster sequencing because multiple workers can’t work together in small rooms.
- High demand for modular work: Workshops often run at full load.
- Festive seasons: Ganpati, Diwali, Navratri — labour availability drops.
This is why the interior timeline in Mumbai usually stays realistic around 4–6 weeks.
Step-by-Step Timeline Breakdown (From Design to Handover)
Here’s what actually happens in a full 2BHK project.
Step 1 — Design Phase (1–2 Weeks)
This is the thinking stage. Without proper design, execution becomes chaotic.
What we do here
- Site visit
- Measurements
- Layout planning
- Mood boards
- Concept options
Where delays happen
- Too many revisions
- Unclear expectations
- Slow decision-making
How you can speed it up
- Finalize your layout early
- Communicate preferences clearly
- Avoid changing the main design again and again
Quick Tip
If you want to speed this stage, download our Layout Decision Checklist.
Step 2 — Material Selection & BOQ Finalization (3–5 Days)
This is where your choices decide your timeline.
We finalize:
- Laminates
- Finishes
- Wardrobe internals
- Countertop materials
- Lights & hardware
Why BOQ matters
The BOQ (Bill of Quantities) locks the materials, so there are no mid-way surprises or delays.
Step 3 — Modular Kitchen & Wardrobe Production (2–3 Weeks)
Most of the main work happens off-site in the workshop.
The process
- Manufacturing
- Quality check
- Packing
- Delivery to your site
What affects production time
- Choice of laminate or acrylic
- Size of the wardrobe
- Appliance compatibility
- Workshop load
Step 4 — Civil Work & Site Preparation (3–7 Days)
This includes:
- Electrical changes
- Plumbing corrections
- Breaking work
- POP panels
- Surface preparation
Why this matters
A clean, level, and prepared site makes modular installations faster and smoother.
Step 5 — On-site Carpentry (1–2 Weeks)
If your project has custom carpentry, this stage begins.
When we need custom carpentry
- Special TV units
- Mandir units
- Bookshelves
- Bay-window storage
- Bed with storage
Why it can take longer
Custom units need cutting, polishing, sanding, and multiple finishing layers.
Step 6 — Modular Installations (4–7 Days)
This is the quickest and most satisfying stage for homeowners.
What gets installed
- Modular kitchen
- Wardrobes
- Storage units
- Loft units
- Countertops
- Appliances
Step 7 — False Ceiling, Painting & Finishing (3–6 Days)
This stage gives the home its final look.
Includes
- False ceiling
- LED lights
- Painting
- Polish
- Touch-up
- Deep cleaning
Total Turnkey Timeline for a 2 BHK in Mumbai (Simple Range)
Standard turnkey time for a 2BHK: 4–6 weeks
Buffer for premium materials or heavy customization: 1–2 weeks
A buffer isn’t a bad sign. It means the work is being done with care, not rushed.
What Causes Delays in 2 BHK Interiors? (And How to Avoid Them)
Here are the real reasons we see in Mumbai:
- Late design approvals
- Pending society permissions
- Festivals (workers unavailable)
- Material unavailability
- Client-requested design changes
Trust Tip
Good interior teams share weekly updates so you always know the progress.
Timeline for Only Modular Kitchen Installation (If You Aren’t Doing Entire Home)
If you’re only getting the kitchen done:
- Manufacturing: 10–15 days
- Installation: 2–5 days
Countertop: 1–2 days
DIY Checklist — How to Ensure Your 2 BHK Project Stays on Schedule
Here’s a simple checklist to keep your timeline under control:
- Approve your designs quickly
- Finalize laminate colors early
- Avoid too many BOQ changes
- Confirm appliance sizes beforehand
- Don’t change layouts mid-project
- Choose reliable modular manufacturers
FREE Resource for You
📄 Mumbai Home Interior Timeline Planner (PDF)
Helps you track each stage and stay in control.

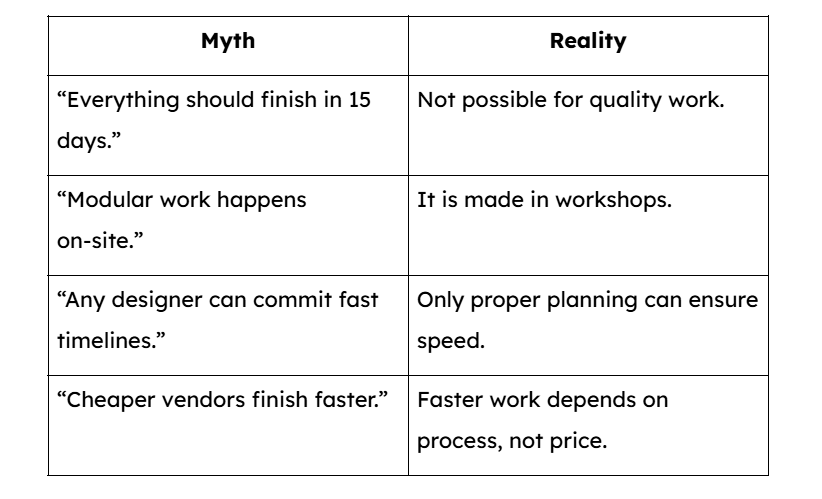

Realistic Expectations Mumbai Homeowners Should Have
Let’s clear some common myths.
When You Should Worry About Delays (Red Flags)
Watch out for these signs:
- Vendor doesn’t share BOQ
- No timeline chart
- No workshop photos
- Too many subcontractors
- Designer never visits site
Frequently Asked Questions
1. What is the timeline for 2BHK refurb in Mumbai?
Usually 4–6 weeks, depending on scope.
2. How long does it take to install a modular kitchen?
Around 2–5 days after manufacturing.
3. What is the turnkey timeline for a 2BHK?
4–6 weeks plus a small buffer.
4. How long does 2BHK interior work take overall?
Typically 1–1.5 months.
5. Can interiors be done in 30 days?
Yes, if scope is limited and materials are pre-finalized.
6. How long does a modular wardrobe take?
Manufacturing: 10–15 days
Installation: 1–3 days
7. Can modular work speed up timelines?
Yes, because most work happens in the workshop.
8. Can we stay in the house during renovation?
Possible, but not comfortable during civil and painting stages.
Final Word — How to Plan Your 2 BHK Interior Without Stress
A smooth interior project is all about planning and coordination.
For most homes in Mumbai, 4–6 weeks is a practical and dependable timeline.
If you want help creating a personal timeline for your 2BHK, feel free to reach out.
We’re always happy to guide you before you take the next step.
